I-95 ETL Northbound Extension – Construction Projects

This project continues the Maryland Transportation Authority’s (MDTA's) efforts to provide a safe and reliable drive for its customers. In addition, improvements will increase quality of life for numerous communities with the construction of several new noise walls and the replacement or rehabilitation of seven bridges that are more than 50 years old. The extension opened to traffic in December 2024 to MD 152, with the full extension to north of MD 24 expected to open to traffic by the end of 2027. The improvements will provide our customers with the option of using the general purpose/non-tolled lanes or using the ETLs. The ETLs will provide a relatively congestion-free commute for all users.

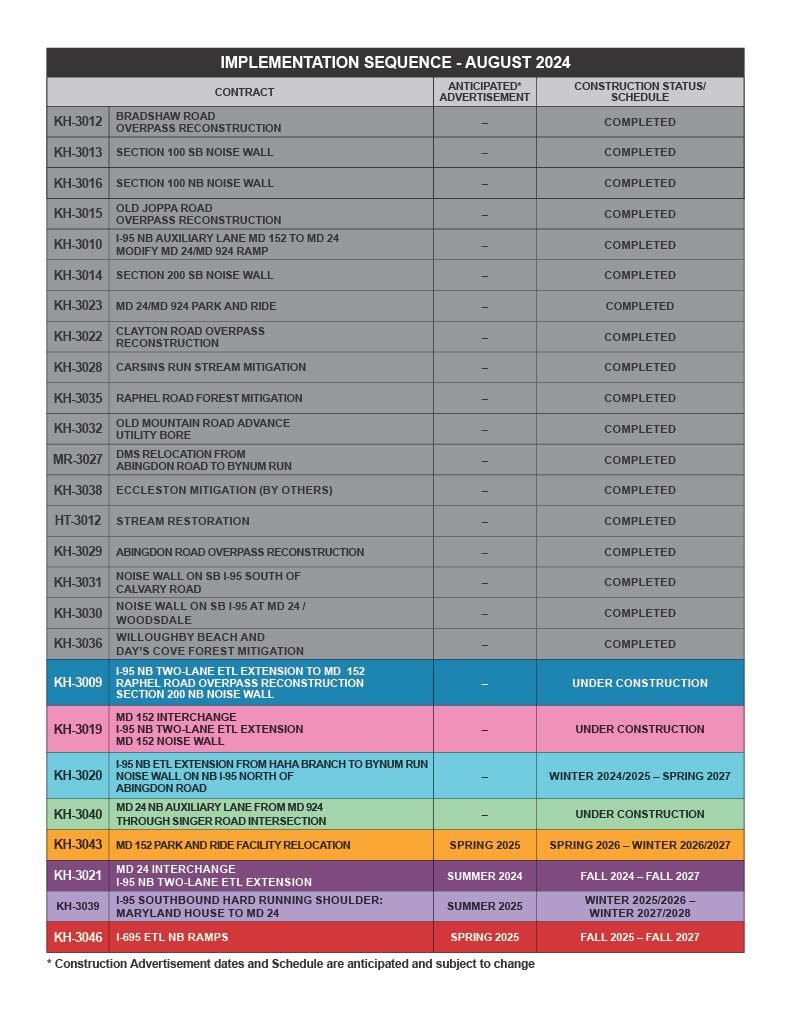

Implementation Sequence August 2024

Contact Information

Maryland Transportation Authority
Attn: Nafiz Alqasem, PE
Deputy Director of Project Development
Office of Engineering and Construction
8019 Corporate Drive, Suite F
Nottingham, MD 21236
I95ETLNB@mdta.maryland.gov

Comments can be submitted by either U.S. mail or email to the above addresses.

WAS THIS PAGE HELPFUL?

Public Calendar

Sep 18

Susquehanna Workforce Network Harford County Regional Job Fair

12 AM

APGFCU Arena at Harford Community College
401 Thomas Run Road
Bel Air, MD 21015

Susquehanna Workforce Network Harford County Regional Job Fair

Visit our table at the Susquehanna Workforce Network Count Regional Job Fair to explore exciting job openings and meet our dynamic team. The MDTA offers competitive salaries, excellent benefits, and career growth opportunities.

Dec 31

PE 20250605

1 PM

IT TEST

This is an IT Test for a public town hall meeting

MDOT Mission
